President Dave's Corner
Thank you to all those who attended the recent annual meeting. Communication is essential to keep
everyone up to date on the many aspects of life on Duck Key.
First of all, I wish to welcome our three new members of the board of directors. They are Laura
Goodman, John Shebel and Jim Boback. Each has strong talents that will truly benefit DKPOA as we move forward.
When you read the newsletter, do you wonder who has put all the time and energy into its creation?
Brian Lancaster deserves all the credit! In addition, Brian has been responsible for the production and distribution of the new DKPOA family membership cards. Currently he is working hard to update our website. He also has created the Facebook page and the YouTube Channel. Next time you see Brian, be sure to thank him for his hard work and dedication.
I have been receiving very positive feedback from DKPOA members who have contacted Flood Zone
Revisions, LLC. The information offered has reportedly been very helpful. Their phone number is 561-702-7936. I also understand that members are making good use of their membership cards for discounts at the Hawk's Cay Calm Waters Spa, as well as for evening meals at Alma and Tom's Harbor restaurants.
Just a reminder that if you have not renewed your DKPOA membership, this most likely will be the
last newsletter that you receive. Having said that, renewals are continuing to come in. Also, new memberships are on the rise.
A large portion of the money in our treasury is being earmarked for beautification. Once the sewer
project is fully completed, a great deal of landscaping will be performed.
Please put Sat. November 17th on your calendar for the Welcome Back Party which will be held at Club
Duck Key. I hope each of you has a healthy and happy summer. I look forward to seeing you next fall.
WASTEWATER UPDATE MARCH 2012
The treatment plant, as previously noted, is complete and continues to function well.
Phases 1,2 and 3 are complete and ready for connection, pending certification by the Florida Department of Environmental Protection(FDEP). This certification is anticipated on or around April 4th, 2012, in which case the "Thirty Day Notices of Service Availability" will be mailed around April 9th. All notices will be mailed simultaneously and not in batches as had been indicated previously.
Phases 4,5, and 6 were awarded to Metro(the contractor for the earlier phases) in February of this year. The current best estimate is that sewer work on Yacht Club will start towards the end of April. Timing is a little uncertain because the FDEP has yet to issue the permit for the dewatering wells which is the first step. Metro will start at the west end of Seaview Circle and proceed east. Completion of these three phases is anticipated in late summer 2013.
Phase 7 will go out for bid shortly with completion slated for the fall of 2013.
Final paving should take place in late fall/early winter 2013.
The Wastewater Laterals Committee was formed by DKPOA several months ago to investigate plumbers and make recommendations to DKPOA members regarding hookups. Their findings were the subject of an extensive presentation at the AGM. The three contractors that the Committee recommended were(in order)
1. 3rd Generation Plumbing 305-743-4245
2. Windy Day Plumbing 305-664-9701
3. MCF Construction 305-522-5643
Members are recommended get multiple quotes, broken out by line item, and not to feel under undue time pressure to connect.
Finally, members are encouraged to provide feedback to other members by rating their contractor experience on a scale of 1(not good) to 5(excellent). Ratings and any comments should be emailed to roger@marriottpartners.com. They will be tabulated on this website and included in the DKPOA newsletter. All submissions will be posted anonymously unless explicit permission is given otherwise.
The FKAA has split the program into five separate contracts as follows:
Contract 1-Phases 1 and 2. Jan 2011-Feb 2012
Contract 2-Phase 3. Feb 2011-Dec 2011
Contract 3-Phases 4, 5, 6. Sept 2011-Dec 2012
Contract 4-Phase 7. May 2012-June 2013
Contract 5-Final Paving. June 2013-Aug 2013

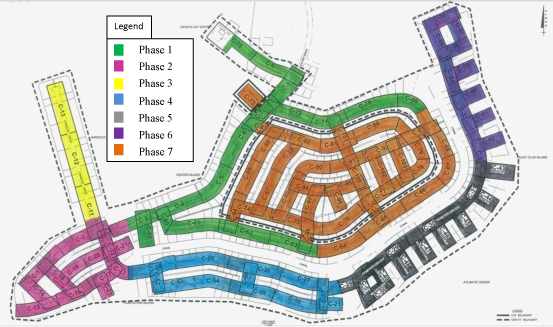

The map below shows the areas involved.
Phases 1,2 and 3 are fully funded and we should see ground breaking in February 2011. The construction schedule appears sensible and there are significant penalty clauses for late completion, so it is likely that these Phases will be completed on or close to schedule.
The remaining four Phases and final paving are in the BOCC's budget for FY 2012; they are not yet funded. FKAA as the general contractor will not proceed to award the remaining contracts until certain of funding from the BOCC. Thus whilst one is finally cautiously optimistic the timing of the remaining phases is still somewhat uncertain. Overall the timing looks, in my opinion, a little ambitious. Given the natural tendency of construction projects to run late, combined with the funding uncertainties, I suspect that we will do well to finalize this project by 2014.
The treatment plant is approximately at the half way point and will be completed in mid 2011, in time to accept hookups from phases 1, 2. and 3. Once each phase is complete homeowners will be required to hookup within 30 days, and will be billed at that time whether hooked up or not. Hookups are the responsibility of the individual homeowner and typically cost around $50/linear foot, according to the FKAA.There is still time to change where on your property line you wish the hookup point to be. DKPOA has established a "Wastewater Laterals Committee" which will meet in early 2011 and attempt to negotiate bulk discounts for our members for sewer hookups from approved contractors. DKPOA is also working with the FKAA on the best ways in which to keep everyone updated on progress and timeframes.
Rates have yet to be set but are likely to be in the range of $50 per month fixed charge and and $7.65 per thousand gallons variable charge. Reclaimed water will be charged at 70% of potable water but its availability will be limited. Once the initial pipes are in the contractors will resurface with 3/4" asphalt and the final resurfacing will be done once the entire project is complete.
This project will be a difficult one for the islands of Duck Key. In the words of Jim Reynolds, Executive Director of FKAA, the process will be "a mess, a dirty process." We as residents need to constantly remind ourselves over the next few years that we are getting the best possible collection system, a very competent general contractor in FKAA, and that we are doing this for our grandchildren.
If you have any questions please feel free to call Roger Marriott at 305-743-3659 or 518-527-33509(cell) or email him at roger@marriottpartners.com.
